(Above) Riverwalk construction east of Clark Street on May 12, 2015. Click on images to view larger versions.
Building the Chicago Riverwalk photos and key datesWith Phase 2 of the Riverwalk starting to open to the public next weekend, here are the events that shaped its journey from concept to reality.
March 20, 2009. The Chicago Riverwalk is not even finished up to the State Street Bridge. There is interest in extending it to Lake Street someday, and Chicago Department of Transportation (CDOT) is looking for money to do that, but there are no immediate plans.
|
October 8, 2012. Mayor Rahm Emanuel challenges CDOT to find creative ways to finance the construction of six more blocks of Riverwalk, from State Street to Lake Street. CDOT asks the United States Department of Transportation for financial help through a program intended for infrastructure projects of regional or national importance. Designs from four firms are unveiled, showing ideas for each of the six blocks.
The Chicago River is our second shoreline, which has played such a critical role in Chicagos early history, the development of our industry, and our quality of life, says Emanuel. It is now time to celebrate this incredible waterway with the completion of the entire Riverwalk project, from Lake Michigan to the confluence of the three branches. |
June 13, 2013. Mayor Emanuel announces Chicago has been approved for a $98.66 million loan to keep building the Riverwalk. The money will come from the Transportation Infrastructure Finance Innovation Act. The Chicago Riverwalk is its first project. The loan, tapped only as needed, has a fixed interest rate of 3.34 percent and is repaid in equal installments every January 1 and July 1 through January 1, 2048. The city must spend the money first, then apply to get reimbursed.

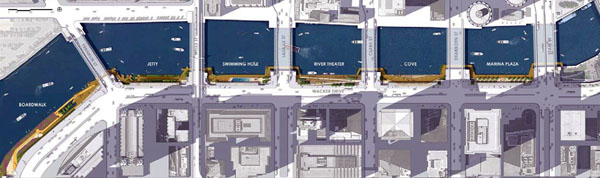

(Above) Map of proposed Riverwalk expansion, from State Street at far right to just past Wolf Point at far left.
September 2013. As construction bids come in, the plan is to start building the first three blocks from State to LaSalle while planners design the last three blocks, from LaSalle to Lake. Ross Barney Architects, the firm that designed the Vietnam Veterans Memorial and a stretch of the Riverwalk that passes under Wabash Avenue, is the architect of this second phase of construction, collaborating with Sasaki Associates, Alfred Benesch & Company, Jacobs/Ryan Associates, and Schuler Shook Inc.
November 8, 2013. Walsh Construction is selected to build from State to LaSalle. CDOT will pay the Chicago-based company $43 million from the loan it got in June from the U.S. Department of Transportation.
|
December 18, 2013. 42nd Ward Alderman Brendan Reilly meets privately with representatives of riverfront buildings.
Before we can benefit from the improvement we must bear with the construction, he tells them, referring to noise, dust, and impact on traffic. Attending the invitation-only event were representatives of at least eight buildings, including Trump International Hotel & Tower, AMA Plaza, Marina City, Leo Burnett Building, 300 North LaSalle, and three office towers on West Wacker Drive. The representatives were given a presentation by CDOT and an approximate construction schedule January 2014 to Spring 2015 to complete the Riverwalk between State and LaSalle and Summer 2014 to Spring 2016 to finish between LaSalle and Lake. |
April 25, 2014. Work resumes after a lull of at least a few days after a hydraulic hammer that pounds steel piles into the ground broke down. A replacement hammer is delivered to the construction site and put into operation.
(Above) On the Riverwalk west of State Street, a construction worker uses hand signals to guide a load of crushed stone to a spot on the river where it is then dumped. He has used the white stick on the ground nearby to measure the depth of the stone so that it can be distributed evenly. As this area is backfilled with aggregate, water mixed with old concrete is filtered and returned to the river.
(Below) Aerial view of Riverwalk construction west of Dearborn Street on June 13, 2014. Wacker Drive at upper left.
June 28, 2014. Workers are now backfilling with crushed stone the areas between the old river wall and the new Riverwalk. As the aggregate goes in, water comes out. It will be filtered and returned to the Chicago River. As they extend the Riverwalk toward LaSalle, construction crews will continue to back-fill with crushed stone the 25-foot-wide gap between the old and new river walls.
|
(Left) Concrete is pumped from a truck on Wacker Drive to a caisson below the Dearborn Street Bridge. |
July 10, 2014. A floating construction barge, 50 feet long by 20 feet wide, takes on water early on a Thursday morning and slowly sinks to the bottom of the Chicago River, east of the LaSalle Street Bridge. There are no injuries. It is unknown why exactly the barge sank or what equipment was lost. Air will be pumped into the barge to help raise it, a process that could take a few days.
July 26, 2014. With the new steel river walls mostly in place, the focus of work on the Riverwalk has turned to concrete. The projects largest concrete pour to date is completed. 700 cubic yards of concrete are poured between Dearborn Street and LaSalle Street. That much concrete, assuming eight-foot ceilings, would fill a 2,360 square foot house.
August 20, 2014. 28 people, who have responded to a request for proposals to manage the Riverwalk, attend a pre-submittal conference at City Hall. They include representatives of Jones Lang LaSalle, Related Midwest, U.S. Equities Realty, and MB Real Estate Services.
August 22, 2014. More than four inches of rain fall at Midway Airport. The Riverwalk is partially flooded, according to CDOT, although most of it appears to be underwater. The State Street Bridge will stay up two more days. The level of the Chicago River, raised by heavy rain over the past two days, is too high for workers to complete installation of a caisson under the bridge.
| (Right) Caisson drilling from a construction barge east of the State Street Bridge. Bores in lower frame, caisson at right. |
|
| (Right) Under-bridge section beneath Dearborn Street (CDOT photo). |
|
|
(Left) Wooden forms west of Clark Street on October 20, 2014. |
December 7, 2014. Most of the larger structural work between State and Clark Streets is finished. Workers are now focused on smaller architectural elements. Concrete work continues west of Clark Street but east of Clark, they are installing parts such as walkways and the granite that will decorate vertical surfaces along the Riverwalk.
| (Right) Workers assemble windows in tenant spaces east of Dearborn Street. |
|
January 6, 2015. With the opening of three blocks of the Riverwalk just months away, the city has not yet decided who the operator will be, but MB Real Estate Services, LLC, has a sporting chance. The Chicago-based real estate company is the only bidder.
The city is free to reject the bid and issue another request for proposals. Whoever is selected will take over for the Chicago Park District, which has been managing retail vendors on the completed Riverwalk between Lake Shore Drive and State Street since 2009. Five vendors that were on the Riverwalk east of Wabash Avenue last year will have to get a short-term concession license from the city to operate again in 2015. While the city says the new operator is welcome to sign existing vendors, new agreements are required and expected to be economically advantageous.
January 17, 2015. Construction crews are working on planters, where trees will go, and pavers on which people will walk. They are also working on the granite walls of Riverwalk rooms between State and Clark Streets. In the arcade spaces under Wacker Drive, where restaurants or other retail vendors will set up shop, doors and windows are being installed. Between Clark and LaSalle Streets, workers are building stairs and ramps.
February 10, 2015. About 20 prospective concessionaires use their imaginations during the first public tour of the Riverwalk. CDOT showed business owners and managers the new interior arcade spaces between Clark and State Streets and existing spaces east of State Street.
|
The group included representatives of Goose Island Brewery, Chicago Electric Boat Company, Urban Kayaks, and a bicycle tour business. |
March 9, 2015. Proposals are due and the city is selecting the first operators of concessions on the Riverwalk. Dicks Last Resort, which overlooks the Chicago River from the southwest corner of Marina City, has submitted a proposal for a bistro that will sell Belgian fries and beer.
| (Right) After months of building forms and laying out rebar, the first concrete is poured onto the slope at River Theater east of Clark Street on March 10, 2015. |
|
